Oswestry Innovation Park (OIP) and the Sustainable Urban Extension

The next phase of works to support the development of the future Oswestry Innovation Park (OIP) and the Sustainable Urban Extension. Please note that the map on this page may not show the precise location of the work, and is intended as a guide only.

SY11 4JA

Stages

B4579 Shrewsbury Road Closure
Maes-Y-Clawdd Road Closure

Status

In progress

The next phase of works to support the development of the future Oswestry Innovation Park (OIP) and the Sustainable Urban Extension will commence in July. The aerial view shows:

(A) Oswestry Sustainable Urban Extension (SUE) (Pickstock Homes)

(B) Oswestry Innovation Park (OIP) (Shropshire Council)

Aerial View Of Oswestry Innovation Park (OIP) Site
Aerial View Of Oswestry Innovation Park (OIP) Site

The work, involving the installation of new drainage along the B5479 Shrewsbury Road to provide the required storm water outfall, will require a section of Shrewsbury Road from Mile End Roundabout to the Maes-Y-Clawdd junction to be fully closed. This is to enable the work to be completed safely, protecting both the workforce and members of the public.

In addition to the above, and to facilitate the continued construction of a new four-arm roundabout by Pickstock Homes, which will form the new access into the housing development, the road closure will be extended to incorporate Maes-Y-Clawdd at Oswestry’s Maesbury Road Industrial Estate northern junction. Working collaboratively and combining the traffic management for both schemes will ultimately reduce future disruption to the highway network.

A summary of the traffic management phases is as follows:

  • Stage 1 – Present day to 13 July – three-way traffic lights on Shrewsbury Road and Maes-Y-Clawdd
  • Stage 2 – 14 July to 31 August – full road closure on Shrewsbury Road and Maes-Y-Clawdd
  • Stage 3 – 1 September to 12 September – road closure on Maes-Y-Clawdd only and two-way traffic lights on Shrewsbury Road
  • Stage 4 – 13 September to 29 October – three-way traffic lights on Shrewsbury Road and Maes-Y-Clawdd

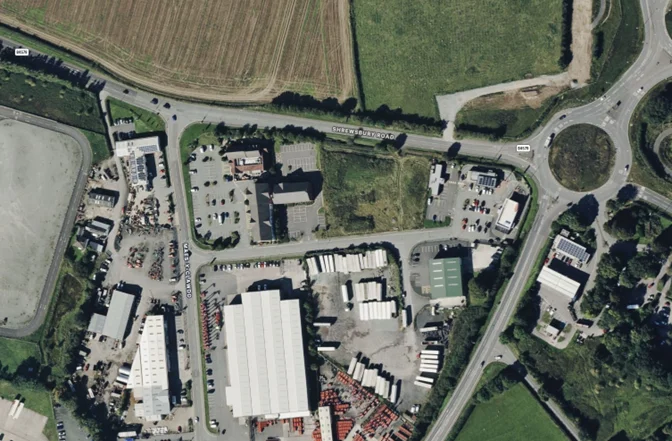

Aerial View Of Mile End Roundabout And Surrounding Area
Aerial View Of Mile End Roundabout And Surrounding Area

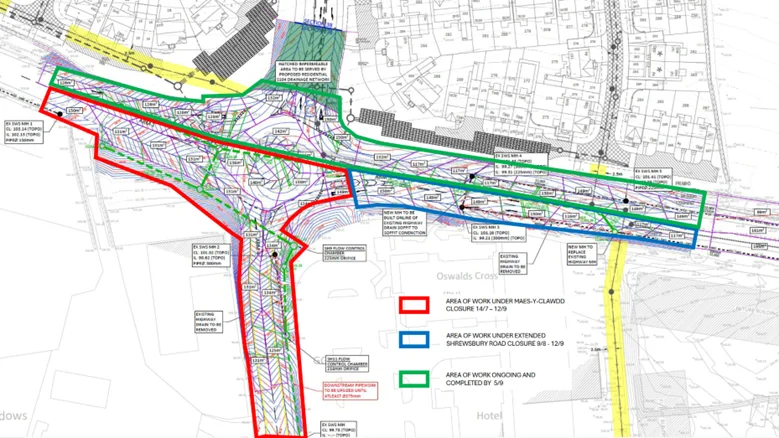

Plan Of Mile End Roundabout Development
Plan Of Mile End Roundabout Development

Traffic management will be in place for the closed section of road with a signed diversion route, suitable for all vehicles, heading north on the A5 and coming back through Oswestry. Access will be maintained to all businesses on the industrial estate, via the A483 Welshpool Road and via Maesbury Road.

Shropshire Council and Pickstock Homes will be working collaboratively to ensure that access is maintained to local businesses during these periods. A one-way in and one-way out system will be created from Morrisons’ Roundabout to maintain access to all businesses for deliveries and customers off the B4579 to the west of the Pickstock Homes works.

Diverting traffic flow during the road closures is expected to reduce queue times at the current temporary three-way traffic signals arrangement at this junction.

Through working with Shropshire Council and combining road closures, Pickstock Homes expects to complete their roundabout works by October 2025, significantly sooner than the original date of January 2026.

Shropshire Council and Pickstock Homes will be working collaboratively with McPhillips and Traffix to minimise inconvenience to the highway network during this period.

If you have any queries relating to the works, please contact us on 0345 6789006. Your query will be logged and directed to the appropriate individual for a response.

Further information is attached to this page.

If your query is specifically relating to the traffic management (temporary signs, cones etc.) related issues, please contact:

  • Traffix West Ltd
  • 0800 819 9001 (24 hours)
  • info@traffixuk.com

Both Shropshire Council and Pickstock Homes apologise for any inconvenience that these essential works may cause. However, the health and safety of the workforce and the public is of paramount importance and the resultant reduction in the construction timeframes will be of great benefit to the area.
